Our progress to date

Since our inception in 2018, we have made significant strides in developing one of Africa’s first utility-scale standalone BESS projects.

Driven by a single mission to reshape the power landscape of Malawi and wider Sub-Saharan Africa, we have moved beyond temporary fixes using a new class of scalable BESS solutions designed to deliver power over several hours in various modes of operation. With the crucial support of Government stakeholders, world-class investors, and strategic advisors, we are proud to be progressing towards financial close on our pioneering projects.

Malawi progress









Energy Storage Africa incorporated in Malawi

2021

Successfully raised c.$170m in equity commitments for Malawi and Kenya BESS projects.

2022

Site acquisition completed through District Commissioner and Ministry of Lands.

2023

ESMP finalised, submitted and approved by MEPA. Environmental permits secured.

Execution of a 25-year land lease for the project site with MITC

2024

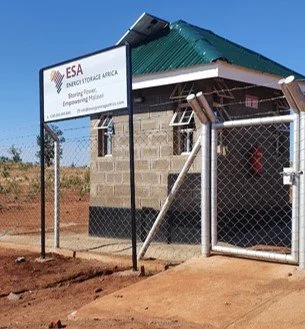

Project site fencing and gatehouse  completed

2025

EPC tender to market and evaluation

2026

Construction commences

2027

Commercial Operations Date
